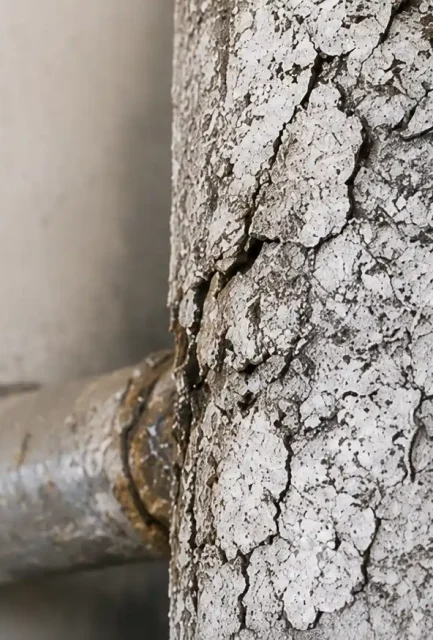

Asbestos was commonly blended into plaster-like pastes and applied directly around hot water pipes, calorifiers, and boilers. Its loose, fibrous structure makes it highly susceptible to damage and deterioration.
We submit the mandatory HSE notification a minimum of 14 days before any licensed lagging removal begins, erect a fully sealed enclosure, and manage the entire process through to independent air clearance.
Controlled Removal Using Specialist Techniques
Independent 4-Stage Air Clearance Testing
From mandatory HSE notification through to independent air clearance testing, we manage every stage of your pipe lagging removal in full compliance.
We submit the mandatory notification to the HSE a minimum of 14 days before removal begins. We handle the notification entirely on your behalf.
We erect a fully sealed negative pressure enclosure around the affected pipework before any lagging is disturbed, with a Decontamination Unit installed at the entry point.
Our licensed operatives use wrap and cut or specialist injection techniques depending on the condition and location of the lagging, suppressing fibre release throughout.

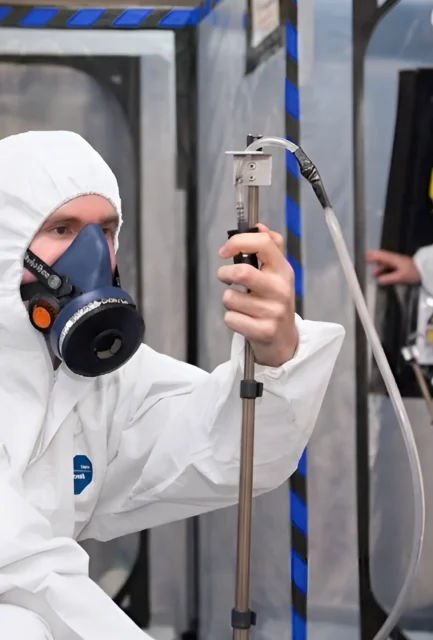

An independent UKAS-accredited analyst carries out the full 4-stage air clearance procedure. No area is handed back until a passed clearance certificate has been issued.
We hold a full HSE asbestos removal licence, the legal requirement for working with pipe lagging and highly friable asbestos-containing materials.
We carry £10m public and employer liability insurance as standard on every licensed pipe lagging removal project across Surrey.
Every project concludes with independent UKAS-accredited 4-stage air clearance testing before any person re-enters the space.
Every project follows a fully documented system of work, reviewed and confirmed before each job commences.
FAQS
The wrap and cut method involves encasing the asbestos lagging in polythene sheeting before the pipe section is cut. This prevents fibre release during cutting by keeping the lagging fully enclosed. The wrapped section is then removed whole and bagged as asbestos waste within the enclosure.
In some cases, encapsulation of stable, undamaged lagging is a recognised management option. However, significantly degraded or actively shedding lagging cannot be encapsulated effectively and must be removed. A licensed survey and assessment will confirm the most appropriate and legally compliant approach for your specific installation.
The duration depends on the extent of the lagging, pipework complexity, and access to the plant room or boiler area. Most residential and light commercial projects are completed within 1 to 3 working days. We confirm the expected programme in the written quote before work begins.
Yes. All occupants must vacate the property or the affected area during licensed pipe lagging removal. The negative pressure enclosure is designed to contain fibres within the work zone, but full evacuation of the surrounding area is required throughout the removal process. We confirm the evacuation zone and expected re-occupation timeline in your written quote before work begins.
The 4-stage clearance procedure is an independently assessed air testing protocol carried out by a UKAS (United Kingdom Accreditation Service)-accredited analyst after all lagging has been removed. It involves a thorough visual inspection, aggressive air sampling, and laboratory analysis to confirm that airborne fibre concentrations have returned to safe levels. No area is handed back for re-occupation until a passed clearance certificate has been issued.
Asbestos pipe lagging is classified as a high-risk, highly friable material under HSE regulations because its loose fibrous structure releases significant quantities of respirable fibres even with minimal disturbance. The Control of Asbestos Regulations 2012 legally requires a full HSE asbestos removal licence for all work involving pipe lagging. Any contractor without this licence cannot legally carry out this work regardless of their general asbestos training.
No. The negative pressure enclosure established around the work area is a controlled zone that only licensed operatives with the correct PPE (Personal Protective Equipment) may enter during the removal process. Any person entering the enclosure without appropriate controls risks serious exposure to respirable asbestos fibres. The area remains restricted until the independent 4-stage air clearance certificate has been issued.
Yes. We submit the mandatory notification to the HSE a minimum of 14 days before any licensed pipe lagging removal can begin, as legally required under the Control of Asbestos Regulations 2012. We handle the notification entirely on your behalf and confirm receipt before scheduling the removal programme. You are not required to contact the HSE directly at any stage.
Yes. We carry out fully licensed asbestos pipe lagging removal across Surrey within our service area, including Guildford, Woking, Epsom, Reigate, and surrounding residential and commercial locations. Contact us with your property postcode and a brief description of the lagging installation and we will confirm availability and a fixed written quote within 48 hours.
